GovCon Cybersecurity | | 21 min read

FedRAMP Compliance: The Complete Guide


Rows of code and data representing the control baselines and evidence behind FedRAMP compliance for cloud service providers
Photo by Markus Spiske on Unsplash

Key Takeaways

FedRAMP compliance is an authorization you maintain, not a certificate you buy.

01

The Level Is Set for You

A FIPS 199 categorization maps your data to Low, Moderate, or High. Most federal software lands at Moderate and its 323 controls. The data decides, not preference.

02

Effort Is Not Evenly Spread

A handful of control families carry most of the work. Access control, system protection, and integrity dominate, so sequence them first rather than spreading effort thin.

03

Authorization Is the Start

The Authority to Operate is a milestone, not the finish line. Continuous monitoring is a permanent operating cost that keeps or loses the authorization every month.

04

Moderate Is the Common Bar

DFARS 252.204-7012 points at requirements equivalent to FedRAMP Moderate, not High. Know your real target before you overbuild or underbuild.

FedRAMP compliance is the price of admission for selling cloud software to the federal government.

It is not a logo you earn once and forget.

The Federal Risk and Authorization Management Program is how a cloud service proves it can safely hold federal data. Behind that simple idea sits a real program: a control baseline drawn from NIST SP 800-53, an independent assessment, an agency decision, and a monitoring commitment that never ends. Providers who treat FedRAMP as a certificate to acquire tend to underfund the parts that actually decide the outcome, which are implementation and the recurring work of staying authorized.

This guide gives you the honest map. What FedRAMP is, how the impact levels and baselines work, where the authorization effort concentrates, the paths to get authorized, the lifecycle from preparation through continuous monitoring, and the evidence an agency reviewer expects to see.

Plan FedRAMP as an operating commitment, not a one time project.

GS Consulting helps cloud providers scope the boundary, model the control effort, and build the evidence pipeline that keeps an authorization current.

Request a FedRAMP Readiness Review

What FedRAMP Is

FedRAMP is a governmentwide program that standardizes how cloud services are assessed and authorized to handle federal information. Instead of every agency running its own security review of the same cloud product, FedRAMP creates one rigorous authorization that agencies can reuse. That reuse is the whole point: do the hard work once, then let multiple agencies rely on it.

The program was codified by the FedRAMP Authorization Act, which put the effort on a permanent legal footing and established a governing board. The mechanics rest on a few fixed pieces: a security categorization from FIPS 199, a control baseline from NIST SP 800-53, an independent test by an accredited assessor, an authorization decision by a federal agency, and ongoing continuous monitoring. Get those five right and you have a defensible authorization. Miss the last one and you can lose it.

Impact Levels and Control Baselines

FedRAMP compliance is not one standard. It scales with how sensitive the data is. A FIPS 199 categorization rates the confidentiality, integrity, and availability of the information, and the highest rating sets the impact level. That level then determines which control baseline you have to implement.

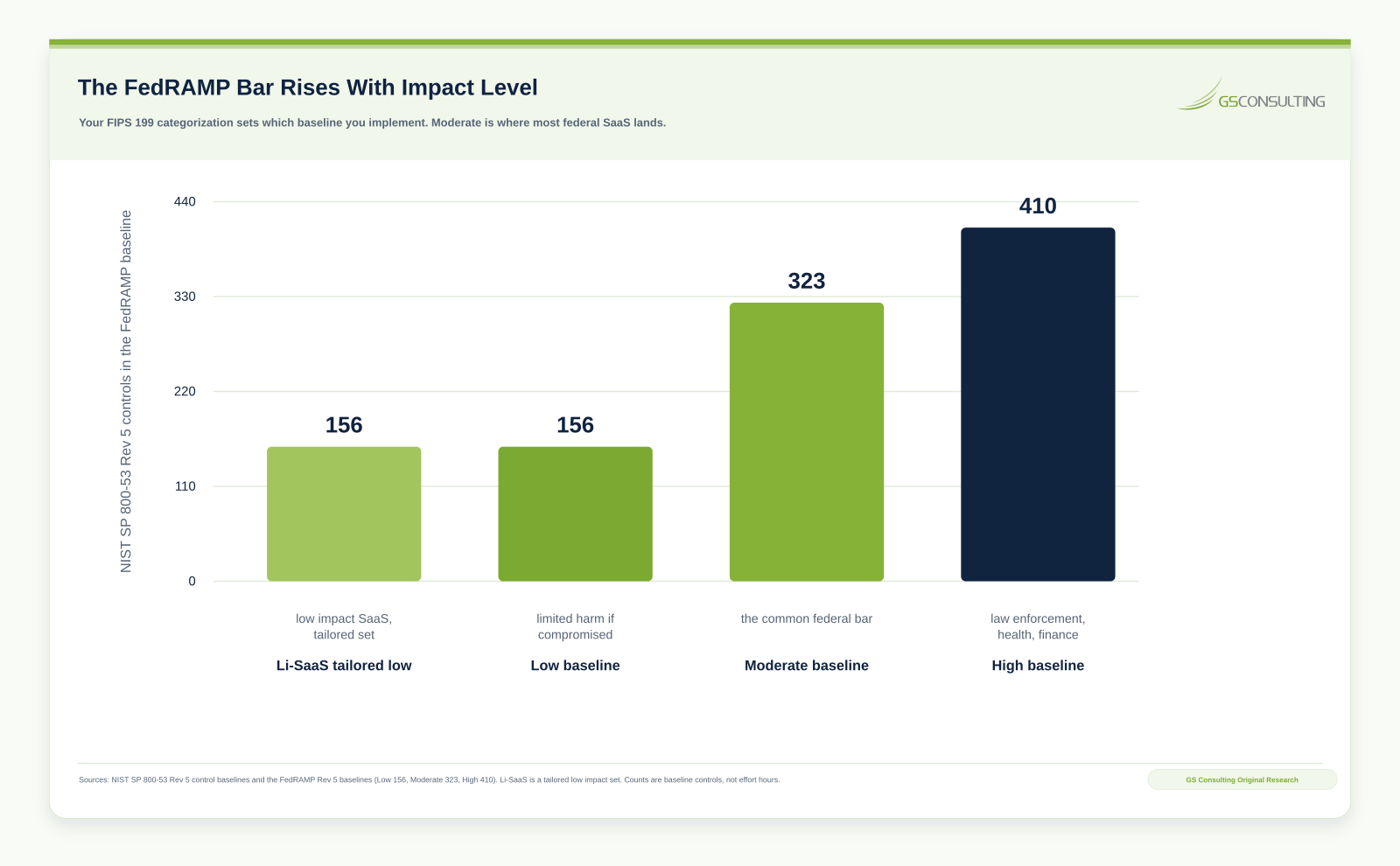

Chart of FedRAMP control counts by impact level showing Low at 156, Moderate at 323, and High at 410 controls from NIST SP 800-53 Rev 5
The control count rises sharply with impact level. Moderate, at 323 controls, is where most federal software lands.

The Low baseline covers systems where a compromise would cause limited harm, and uses 156 controls. There is also a tailored Low path called Li-SaaS for low impact software with a narrow footprint. The Moderate baseline is the common federal bar, with 323 controls, and it is where the majority of federal software services sit. The High baseline, at 410 controls, is reserved for the most sensitive workloads such as law enforcement, emergency services, and health or financial data where a breach could cause severe or catastrophic harm.

One point trips up defense contractors constantly. DFARS 252.204-7012 requires that a cloud service handling Covered Defense Information meet security requirements equivalent to the FedRAMP Moderate baseline. That is a Moderate equivalence requirement, not a demand for High. A High authorization exceeds the requirement, but the obligation itself points at Moderate. If your work touches Controlled Unclassified Information in the cloud, our guide on secure cloud architecture for federal contractors handling CUI shows how that equivalence plays out in a real design.

Original Research: The FedRAMP Authorization Effort Index

Control counts tell you how many requirements you face. They do not tell you where the work actually lands. To close that gap, GS Consulting built the FedRAMP Authorization Effort Index. We took the NIST SP 800-53 Rev 5 control families in the Moderate baseline and, using baseline control counts, evidence depth, and the continuous monitoring burden as anchors, assigned each family a relative effort weight. The weights are scaled so the heaviest family reads 100, which makes the proportions easy to see at a glance.

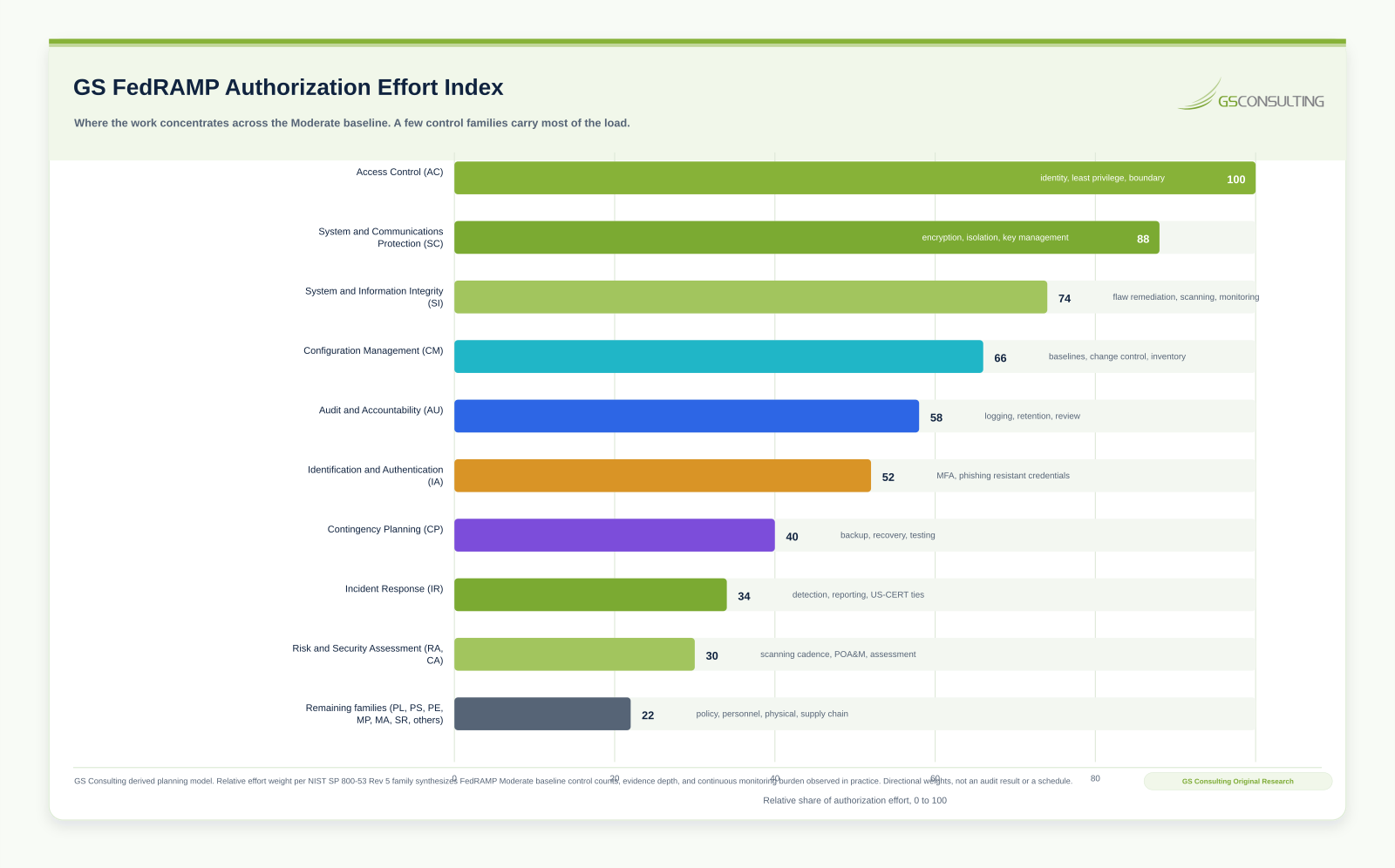

GS FedRAMP Authorization Effort Index ranking access control highest, followed by system and communications protection, system and information integrity, configuration management, and audit and accountability
Access control, system protection, and integrity carry most of the authorization effort. Sequence those families first.

The ranking is the takeaway. Access Control sits at the top because identity, least privilege, and boundary enforcement touch every component and generate the most evidence. System and Communications Protection follows close behind, since encryption, isolation, and key management are architecture level decisions that are painful to retrofit. System and Information Integrity comes next, because flaw remediation, scanning, and monitoring feed the continuous monitoring engine you will run forever. Configuration Management, Audit and Accountability, and Identification and Authentication fill the heavy middle. The remaining families, from planning and personnel to physical and supply chain, matter for completeness but carry less of the build effort.

Read the index top to bottom and the strategy writes itself. Do not treat 323 controls as a flat checklist. Concentrate early effort on identity, system protection, and integrity, because those families both carry the most work and set the foundation everything else depends on. If you are approaching this from the standard behind the controls, our NIST SP 800-171 explainer shows how the same control thinking maps to the defense side.

Authorization Paths and Levels

Two questions decide your FedRAMP route: which level applies, and how you get authorized. The level, as covered above, is set by the data. The path has shifted with the program's modernization, so it is worth being current.

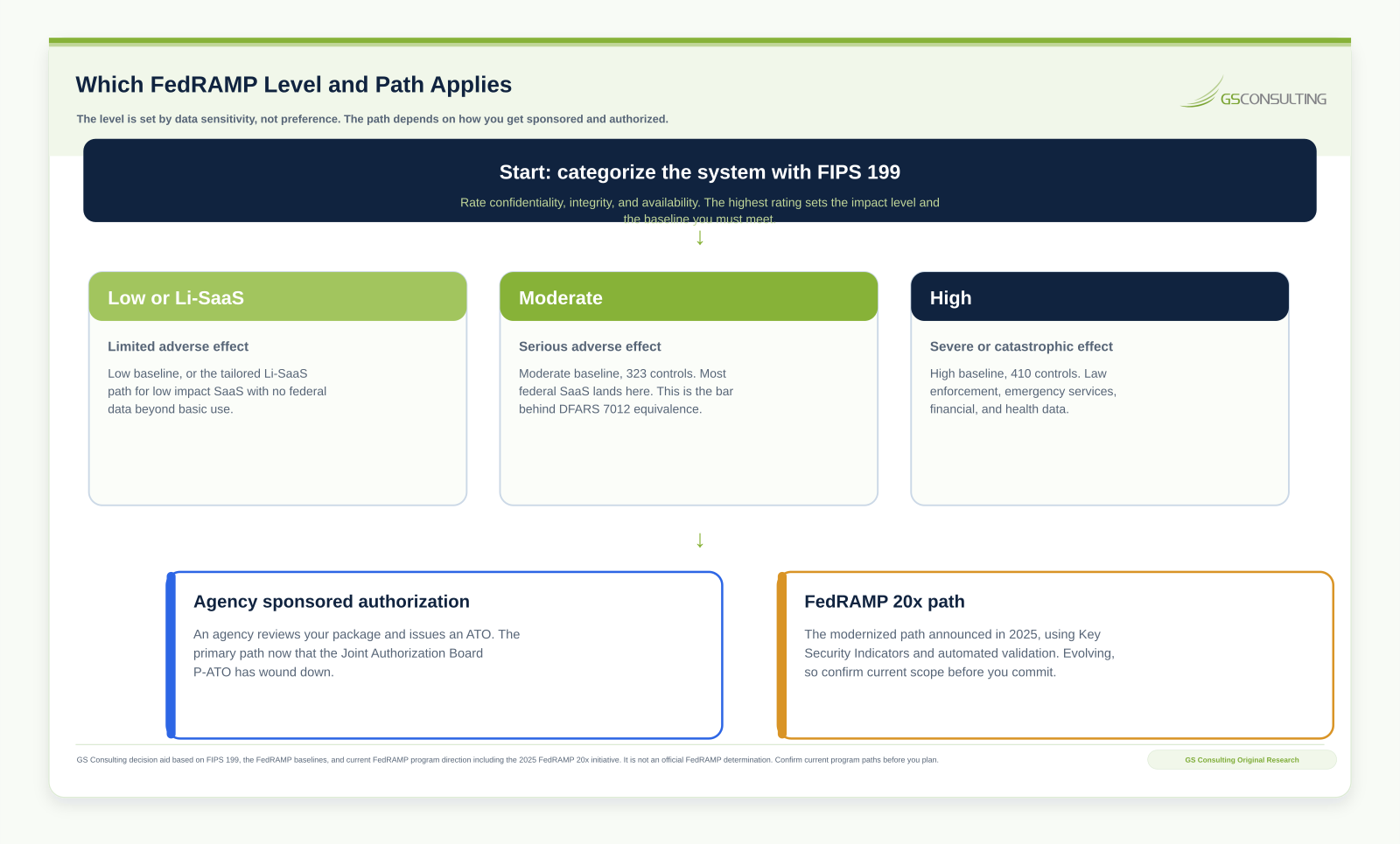

FedRAMP decision gate starting with FIPS 199 categorization, branching to Low, Moderate, or High baselines, then to agency sponsored authorization or the FedRAMP 20x path
Start with FIPS 199, land on a baseline, then choose an authorization path. Agency sponsorship is the primary route today.

Historically there were two paths: an authorization sponsored by a single agency, and a provisional authorization from the Joint Authorization Board. The Joint Authorization Board path has wound down, and agency sponsored authorization is now the primary route. In 2025 FedRAMP announced the FedRAMP 20x initiative, a modernized approach built around Key Security Indicators and automated, machine readable validation that aims to make authorization faster and cheaper to sustain. FedRAMP 20x is still evolving, so treat it as a direction to confirm against current program guidance rather than a fixed process. The practical takeaway is unchanged: you need an agency willing to sponsor and rely on your authorization, and you need a package ready for an accredited assessor.

The Authorization Journey

FedRAMP authorization moves through a predictable lifecycle. Knowing the shape of it prevents the classic mistake of pouring everything into passing the assessment and nothing into what comes after.

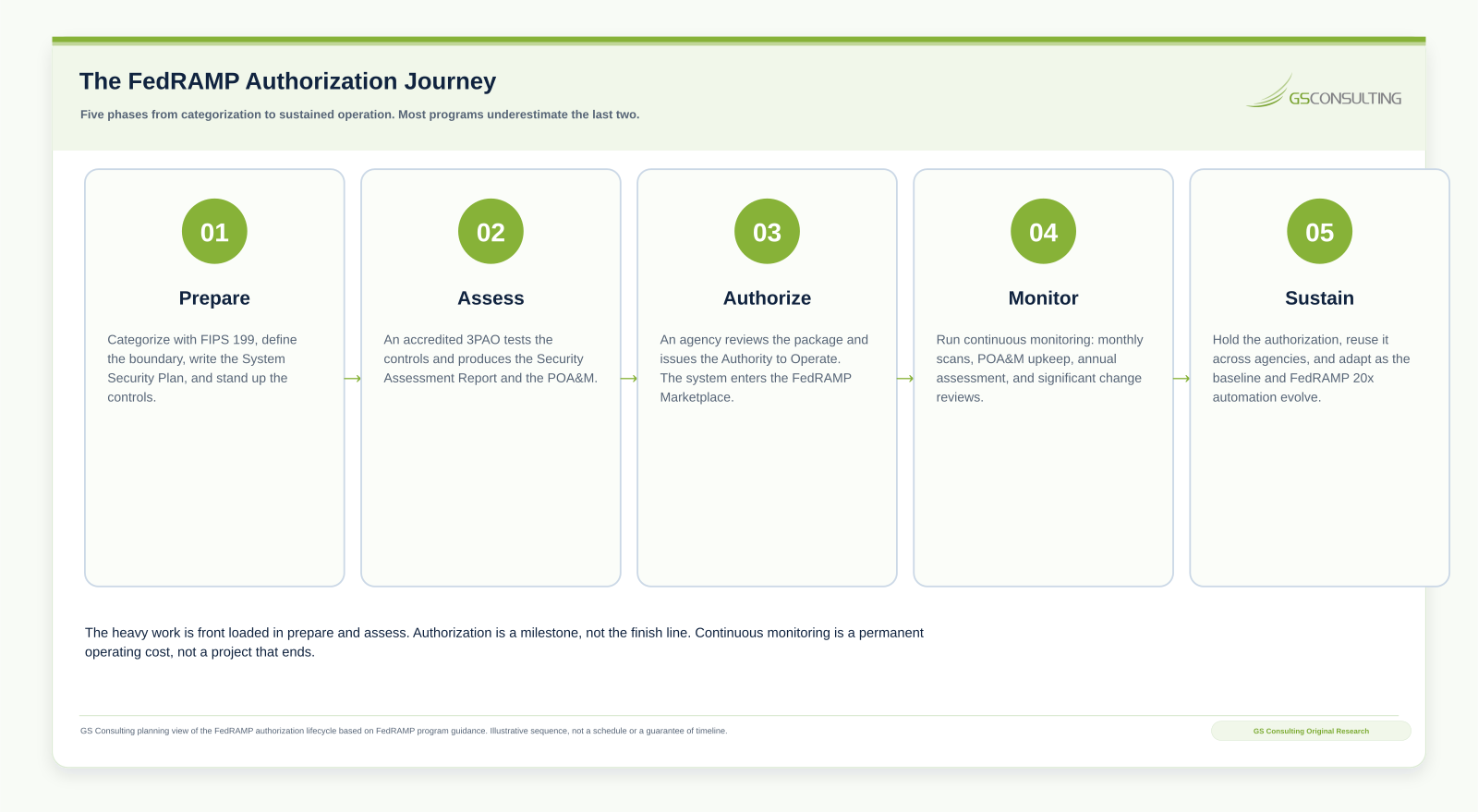

Five phase FedRAMP authorization journey: prepare, assess, authorize, monitor, and sustain, moving left to right
Five phases from categorization to sustained operation. The last two phases are where authorizations are actually kept.

In the prepare phase you categorize the system, define the authorization boundary, write the System Security Plan, and implement the controls. In the assess phase an accredited third party assessment organization tests those controls and produces the Security Assessment Report and the Plan of Action and Milestones. In the authorize phase an agency reviews the package and issues the Authority to Operate, and the service is listed in the FedRAMP Marketplace so other agencies can reuse it. Then the work that never ends begins: the monitor phase runs continuous monitoring, and the sustain phase carries the authorization forward, reusing it across agencies and adapting as the baseline and the FedRAMP 20x automation evolve. Most programs underestimate the effort in those last two phases by a wide margin.

Continuous Monitoring

If FedRAMP has a hidden cost, this is it. Authorization is not the finish line. It is the moment your recurring obligations begin, and those obligations are what keep the authorization valid.

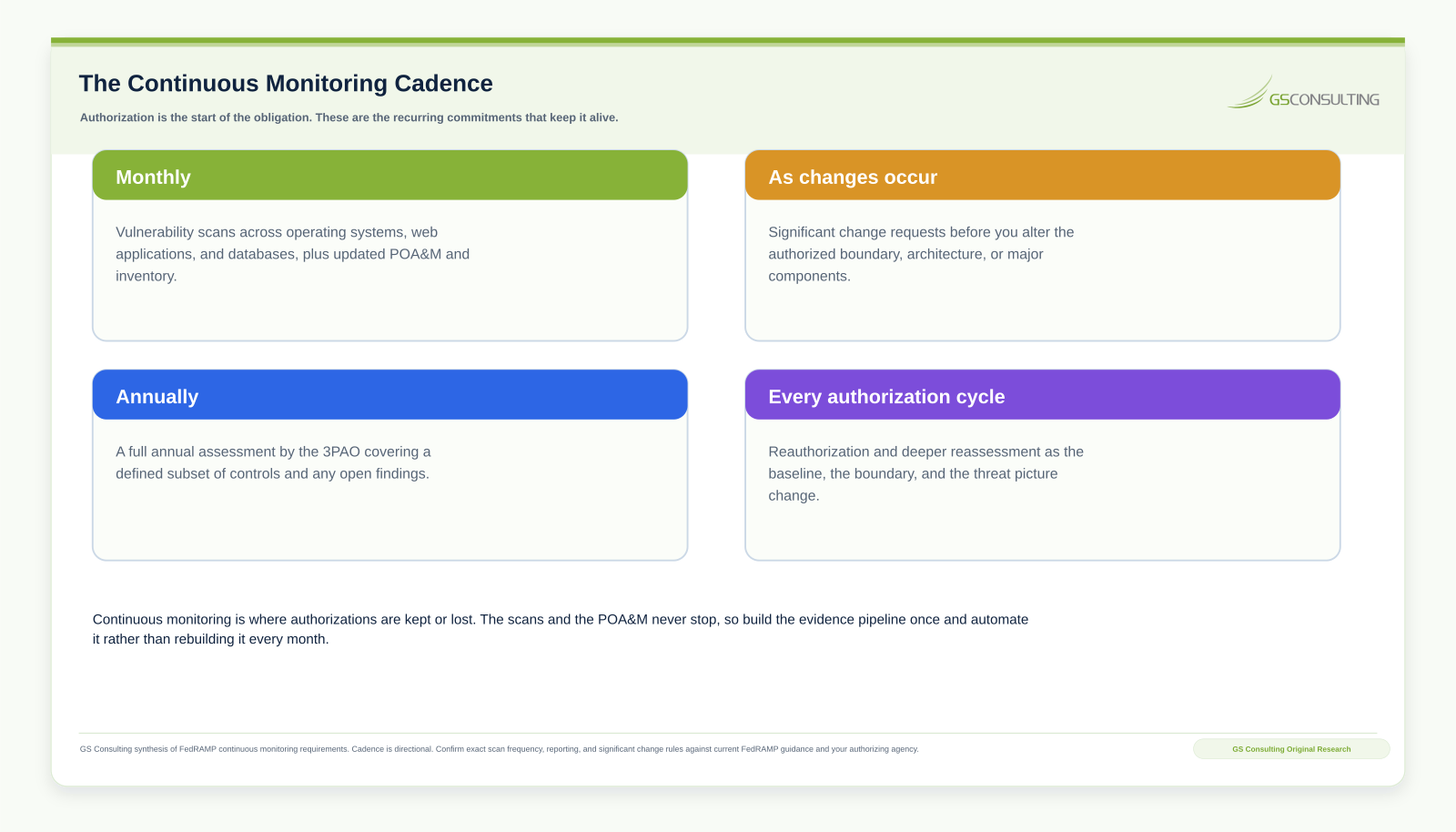

FedRAMP continuous monitoring cadence showing monthly scans, change based significant change requests, annual assessment, and reauthorization each cycle
The continuous monitoring commitments that keep an authorization alive, from monthly scans to each reauthorization cycle.

Every month you run vulnerability scans across operating systems, web applications, and databases, and you keep the Plan of Action and Milestones current with every open finding, its owner, and its target date. Whenever you plan to alter the authorized boundary or a major component, you submit a significant change request before making the change. Once a year the third party assessor performs an annual assessment covering a defined subset of controls. And each authorization cycle brings a deeper reassessment as the baseline, the boundary, and the threat picture change. This is exactly the kind of recurring evidence work that rewards automation, the same argument we make in automating NIST 800-171 compliance evidence. Build the pipeline once and the monthly cadence becomes a background task instead of a scramble.

The Authorization Evidence Packet

An agency reviewer and a third party assessor expect a specific set of artifacts. Assembling them well is most of what separates a smooth authorization from a stalled one.

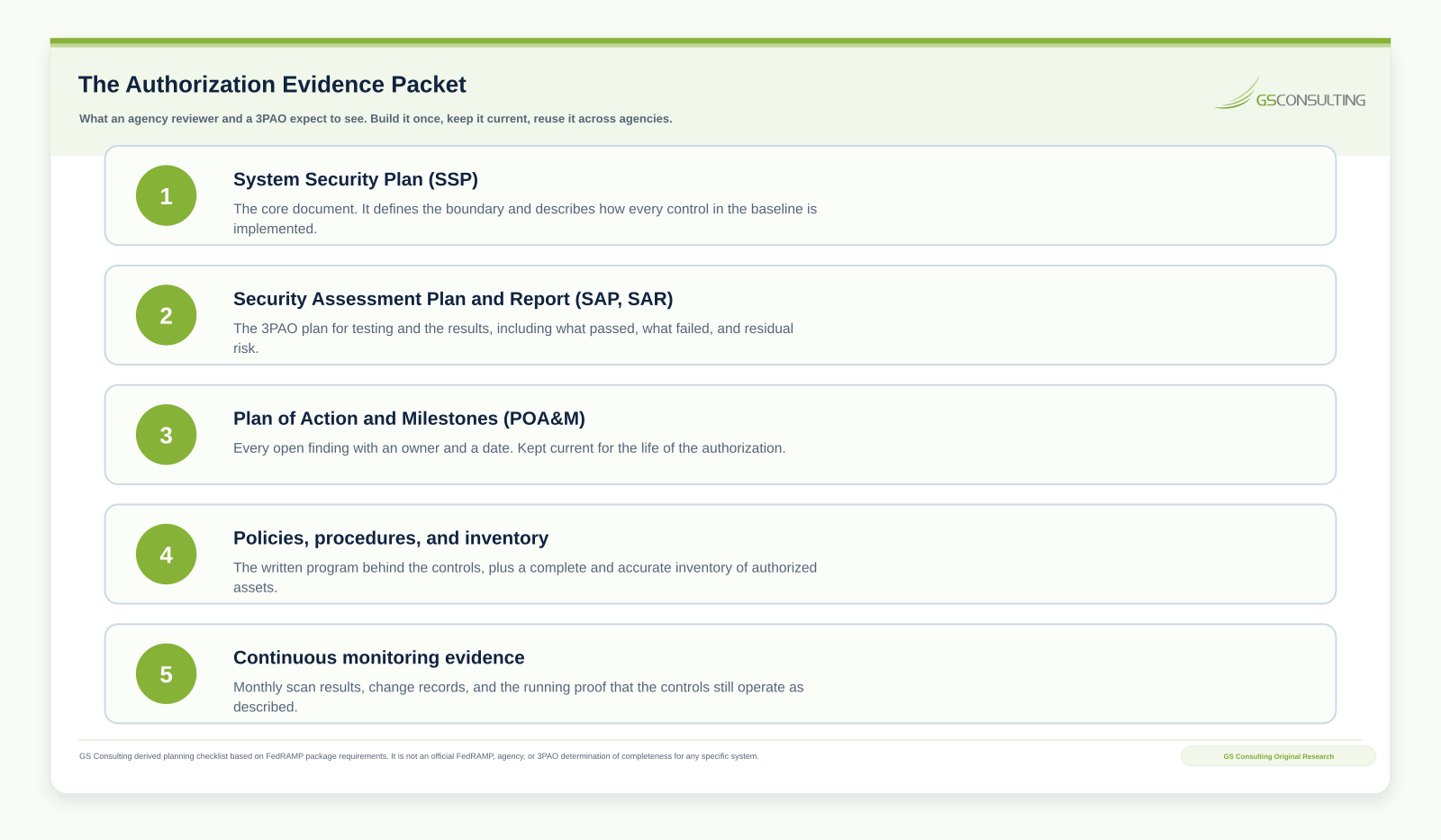

FedRAMP evidence packet checklist: System Security Plan, assessment plan and report, plan of action and milestones, policies and inventory, and continuous monitoring evidence
The core authorization artifacts. Build them once, keep them current, and reuse them across agencies.

The System Security Plan is the spine of the package. It defines the authorization boundary and describes how every control in your baseline is implemented. The Security Assessment Plan and the Security Assessment Report capture how the assessor tested the controls and what they found, including residual risk. The Plan of Action and Milestones tracks every open finding with an owner and a date, and it stays live for the entire authorization. Around those sit the policies, procedures, and a complete asset inventory that show the program is real, plus the running continuous monitoring evidence that proves the controls still operate. The best way to keep controlled data out of the wrong hands while you build all of this is a disciplined boundary and a governed platform, which is where secure AI automation for regulated organizations and a tight cloud architecture pay off.

Done in this order, FedRAMP becomes a managed program with a predictable rhythm rather than an open ended scramble. That is the standard worth holding: categorize honestly, sequence the heavy control families first, build the package once, and treat continuous monitoring as the permanent operating commitment it is.

Research Sources and Caveats

The GS FedRAMP Authorization Effort Index and the planning views in this guide are GS Consulting derived planning tools based on cited public sources and documented assumptions. They are not official FedRAMP, agency, third party assessor, NIST, DoD, legal, or audit determinations, and they are not a schedule, a quote, or a guarantee of authorization. The control counts and program facts are drawn from the sources below. The effort weights, the lifecycle framing, and the monitoring cadence are GS planning assumptions and will vary with your boundary, your architecture, your authorizing agency, and the current state of the FedRAMP program.

FedRAMP is modernizing. The FedRAMP 20x initiative and related program changes are evolving, so confirm the current baselines, paths, and monitoring requirements against official FedRAMP guidance and your authorizing agency before you plan.


Frequently Asked Questions About FedRAMP Compliance

What is FedRAMP compliance?

FedRAMP is the Federal Risk and Authorization Management Program. It is the standardized way a cloud service earns authorization to store, process, or transmit federal data. FedRAMP compliance means a cloud service provider has implemented a defined baseline of NIST SP 800-53 controls, had them tested by an accredited third party assessor, received an authorization from a federal agency, and keeps the controls under continuous monitoring. It is not a one time certificate. It is an authorization you have to maintain.

What are the FedRAMP impact levels?

FedRAMP uses the FIPS 199 impact levels: Low, Moderate, and High, plus a tailored Low path called Li-SaaS for limited low impact software. The level is set by the sensitivity of the data and the harm that would result if it were compromised, not by preference. Most federal software lands at Moderate, which uses 323 controls from NIST SP 800-53 Rev 5. Low uses 156 and High uses 410.

How long does FedRAMP authorization take?

It varies widely with your starting maturity and the path you take. Preparing the environment and the System Security Plan, completing the third party assessment, and getting an agency to review and authorize the package has historically taken many months to well over a year for providers starting from a commercial posture. The FedRAMP 20x initiative announced in 2025 aims to shorten this with automation and Key Security Indicators, but the timeline still depends heavily on how ready your environment and evidence are before the assessment begins.

Is FedRAMP the same as the DFARS requirement for defense contractors?

Not exactly, and the distinction matters. DFARS 252.204-7012 requires that a cloud service used to handle Covered Defense Information meet security requirements equivalent to the FedRAMP Moderate baseline. That is a Moderate equivalence requirement, not a mandate for FedRAMP High. A service authorized at High exceeds it, but the obligation itself points at Moderate. Confirm what your specific contract and data require before assuming a level.

What does continuous monitoring involve under FedRAMP?

Continuous monitoring is the recurring work that keeps an authorization alive. It includes monthly vulnerability scans across operating systems, web applications, and databases, keeping the Plan of Action and Milestones current, submitting significant change requests before altering the authorized boundary, and completing an annual assessment by the third party assessor. The monitoring never stops, which is why building an automated evidence pipeline early is worth more than any single control.
